Article

August 05, 2026

Quality Indicators for BIM Information Governance in Transportation Infrastructure

José Vinícius Silva Martins; Suranny Jiménez Chacón

DOI: 10.22167/2675-6528-202601003

Article prepared by the ResumeAI tool, an artificial intelligence solution developed by the Pecege Institute focused on synthesis and writing.

Abstract

The adoption of Building Information Modeling (BIM) in transportation infrastructure projects has expanded the possibilities for information integration throughout the lifecycle of the developments, but it has also highlighted challenges related to the quality and interoperability of data present in digital models. In this context, the objective was to develop a framework of performance indicators and objective audit criteria to evaluate the informational conformity and maturity of BIM models applied to transportation infrastructure. The research was characterized as applied, with a mixed approach and a design based on multiple case studies, involving two projects in the executive design phase, one road and one rail. Initially, a literature review and documentary analysis of contractual requirements were carried out, including EIR, BEP, and Level of Information Need, in light of the PMBOK and ABNT NBR ISO 19650 series references. Subsequently, BIM models in IFC 4.3 format were subjected to informational audit through rules structured in Information Delivery Specification (IDS), verified in an openBIM environment. The results showed recurring failures mainly associated with the absence or inconsistency of mandatory attributes and interoperability limitations between platforms. Based on these findings, quantitative indicators were structured to measure different dimensions of the informational quality of the models, contributing to strengthening BIM information governance and supporting quality control in infrastructure projects.

Keywords: BIM; Infrastructure; Information; Quality; Transport.

1. Introduction

The implementation of Building Information Modeling (BIM) represents a paradigm shift in project management within the Architecture, Engineering, and Construction (AEC) sector, especially in complex ventures such as transportation infrastructure. The ability to create and manage digital representations of an asset’s physical and functional characteristics enhances interdisciplinary collaboration, conflict detection, schedule and cost optimization, and infrastructure lifecycle management. In linear projects, like highways and railways, BIM also facilitates the integration of geospatial, geotechnical, and design data, providing a more comprehensive view for decision-making (Costin et al., 2018; Zhao et al., 2019).

Despite these benefits, the effectiveness of BIM is directly related to the quality and governance of the information managed in digital models (Song et al., 2017). The intensification of its use in infrastructure projects has highlighted challenges related to the consistency, accuracy, completeness, and interoperability of data. The absence of clear standards and objective metrics to evaluate informational quality results in models with semantically poor or inconsistent information, compromising critical analyses such as quantities, budgets, and construction planning (Tomczak et al., 2024).

Furthermore, even with the adoption of open formats such as Industry Foundation Classes (IFC) (ABNT, 2023), difficulties still persist in the fluid exchange of information between different platforms and agents involved in the project (Xu et al., 2018). This reality points to a practical and theoretical gap in ensuring the reliability and usability of BIM data throughout the project lifecycle, impacting decision-making and operational efficiency.

In this context, the quality of BIM information becomes a relevant aspect for the reliability of models and for meeting the intended uses in transportation infrastructure projects. The theoretical foundation of this work is based on four complementary pillars. ABNT NBR ISO 19650 (ABNT, 2022) guides information management throughout the asset’s lifecycle, establishing a framework for collaboration and information exchange. IFC 4.3 acts as an openBIM standard for data exchange and preservation between different platforms, aiming for interoperability and longevity of digital information.

The Information Delivery Specification (IDS) (buildingSMART International, 2025a) allows for the transformation of informational requirements into automatically verifiable rules, which is crucial for audit automation. The PMBOK (PMI, 2017), in turn, provides the logic for planning, managing, and controlling quality, integrating project management practices into the BIM information context. These references allow for the articulation of informational requirements, interoperability, and quality management, establishing the conceptual basis for transforming normative and contractual demands into verifiable audit criteria, justifying the need for a systematic approach to quality assessment.

Given the growing complexity of infrastructure projects and the need to ensure the reliability of digital models, the general objective of this work is to propose a framework of technical and managerial indicators to assess the informational compliance and maturity of BIM models applied to transportation infrastructure projects. The proposal seeks to convert informational requirements into metrics applicable to auditing, quality control, and BIM information governance, contributing to support technical and managerial decisions in infrastructure projects.

2. Material and Methods

The research is characterized as applied, aiming to solve a practical problem in the management of information quality in transportation infrastructure projects that use Building Information Modeling (BIM). A mixed approach was adopted, with qualitative and quantitative phases. The qualitative phase involved the interpretation of normative requirements and documentary analysis of project artifacts, while the quantitative phase focused on the proposal of measurable performance and compliance indicators. Regarding objectives, the research had an exploratory character, by proposing a new structure of indicators, and descriptive, by characterizing informational quality failures in case studies.

The main design was a multiple case study, focused on two transport infrastructure projects (one road and one rail), both developed in BIM. Data collection included a literature review, based on PMBOK (PMI, 2017), ABNT NBR ISO 19650 (ABNT, 2022), and openBIM standards (IFC ABNT, 2023; IDS buildingSMART International, 2025a). Complementarily, documentary research was carried out on artifacts such as the BIM Execution Plan (BEP), Exchange Information Requirements (EIR), contractor information exchange requirements, and BIM models in IFC 4.3 format (buildingSMART International, 2025b).

For the empirical evaluation of informational quality, two representative cases provided by the multinational Egis Group were selected, both in the executive design phase: a road development (section of a duplicated federal highway with an overpass intersection) and a railway development (interconnection between a railway yard and an iron plant). This selection aimed to cover typological, disciplinary, and technological diversity, reflecting real scenarios of linear projects. The road and railway models analyzed are presented in Figure 1 and Figure 2, respectively.

Figure 1. Federated model of the road project in Navisworks Manage

Source: Original survey data

Figure 2. Federated model of the railway in Navisworks Manage

Source: Original survey data

The models included linear infrastructure disciplines such as geometry, earthworks, paving, drainage, special structures (OAE), permanent way, signaling, retaining walls, and interferences. They were developed in various BIM software and exported to the IFC 4.3 format, an openBIM standard. This diversity allowed for the evaluation of the quality of the modeled information and failures in export, interoperability, and semantic consistency.

Table 1 details the technical characterization of the projects, including infrastructure type, disciplines, exchange formats, IFC standard, and BIM uses foreseen in the contractual EIR and BEP. The intentional choice of road and railway ventures, with distinct technical contexts, aimed to identify informational failure patterns in real BIM development environments, without the purpose of statistical generalization, and to substantiate the informational audit protocol.

Table 1. Technical characterization of the projects analyzed in the multiple case study

Infrastructure typeof included DisciplinesExchange formatof IFC StandardComputer programMain BIM uses foreseen in the EIR and BEP
RoadLinear infrastructure: geometry, earthworks, paving, drainage, signage and safety devices, topography, landscaping, retaining structures, interferences, complementary works, geotechnics and lightingDWG/NWC/IFCIFC 4.3Civil 3DModeling of existing conditions, authorial design, code validation
RoadGeology: soundings, water level and geological layersIFC/NWCIFC 4.3Leapfrog WorksGeological analyses (input to the BIM process)
RoadSpecial Works of Art (SWA): viaductsRVT/NWC/IFCIFC 4.3RevitModeling of existing conditions, authorial design, code validation
RailwayLinear infrastructure: permanent way (rails, sleepers, ballast), railway geometry, earthworks, drainage, signaling and safety devices, topography, landscaping, retaining structures, interferences, complementary works, geotechnics and lightingDWG/NWC/IFCIFC 4.3Civil 3DModeling of existing conditions, authorial design, code validation
RailwayGeology: soundings, water level and geological layersDWG/NWC/IFCIFC 4.3Leapfrog WorksGeological analyses (input to the BIM process)
RailwaySpecial Works of Art (SWA): bridges, viaducts, underpasses and overpassesRVT/NWC/IFCIFC 4.3RevitModeling of existing conditions, authorial design, code validation
Road and RailBIM Coordination: coordination and federated modelsNWF/NWDNavisworks Manage3D spatial coordination
Road and RailBudgetelFC/IFCIFC 4.3AltoQi VisusQuantity extraction and cost estimation
Source: Original survey data
Note: In the present study, the term code validation refers to the verification of contractual requirements defined in the EIR and BEP, such as codes of the construction information classification system adopted in the contracts, not being restricted to automated regulatory validations

3. Results and Discussion

Information governance and quality management in BIM infrastructure projects

The literature on BIM applied to transportation infrastructure shows that the benefits of multidisciplinary coordination, reliability of quantities, and decision-making support directly depend on the quality and structuring of information in digital models. In linear projects, such as highways and railways, the integration of geometric, geospatial, and semantic data requires well-defined informational requirements to avoid inconsistencies throughout the asset’s lifecycle (Costin et al., 2018; Zhao et al., 2019). In this context, information governance plays a central role in ensuring that BIM models meet analytical, managerial, and operational demands.

Based on ABNT NBR ISO 19650, the definition of these requirements occurs through the formalization of the client’s needs in documents such as the EIR and the BEP, which establish responsibilities, formats, acceptance criteria, and required information levels. The concept of Level of Information Need (LoIN) complements this process by objectively specifying the geometric, alphanumeric, and documentary requirements by phase and purpose (ABNT, 2022; ISO, 2024). The systematization of these requirements was organized by lifecycle phase, responsible actor, and delivery type, as presented in Table 2, allowing normative guidelines to be converted into verifiable operational criteria.

Table 2. Matrix of informational requirements according to ABNT (2022) and ISO (2024)

PhaseResponsibleDelivery typeGeometric requirementsAlphanumeric requirementsDocumental requirementsVerification criterion
Conceptual projectGeometric designerModelsAxis, grade, corridors, and typical sectionsSegment identifier, functional classDescriptive memorialGeometric presence and minimum attributes
Executive projectTechnical disciplines (OAE, drainage, paving, among others)Models and dataDetailed geometry of elementsComplete property sets, classification, materialsTechnical reportsPercentage of mandatory attributes filled
ConstructionBuilderAs-built modelsAs-built geometryQuantities, service codes, statusConstruction reportsQuantitative consistency × budget
Operation/maintenanceOperatorAsset database/modelAsset representative geometryUnique identifier, lifespan, maintenance planAsset manualData integrity and traceability
AllBIM ManagerReports/documentsBEP, validation records, IDS reportsDocumental compliance
Source: Original research results

However, the literature on openBIM interoperability shows that the mere adoption of the IFC format does not guarantee informational quality or semantic consistency. Recurring problems include loss of meaning during export, absence of mandatory attributes, inconsistent use of classifications, and software compatibility limitations (Xu et al., 2018; Costin et al., 2018). These challenges were synthesized in the cause-problem-effect-impact chain presented in Figure 3, highlighting that interoperability constitutes both a technical and a managerial challenge. In response, standards such as IFC 4.3 and IDS have been proposed to structure requirements in a machine-auditable format, contributing to the reduction of inconsistencies (buildingSMART International, 2025a; Tomczak et al., 2024).

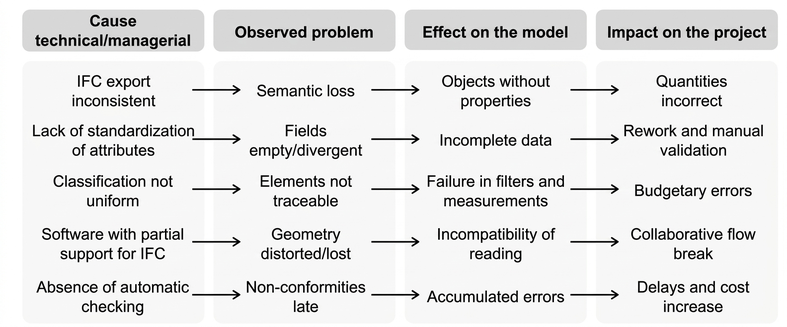

Figure 3. Cause–problem–effect–impact chain of openBIM interoperability challenges in infrastructure projects according to Xu et al. (2018) and Costin et al. (2018)

Source: Original research results

From the consolidation of these normative and theoretical references, a systematized classification of recurring informational failures was structured, organized according to information quality dimensions, such as completeness, consistency, accuracy, semantic conformity, and interoperability, as presented in Table 3. This classification allows associating each type of deviation with its potential causes and impacts, connecting contractual requirements and interoperability challenges to objective evaluation criteria.

Table 3. Classification of recurrent informational failures in BIM infrastructure models, based on Song et al. (2017), Xu et al. (2018), ABNT (2022) and Tomczak et al. (2024)

Quality dimensionDefinitionPractical examplesDetection method
CompletenessMandatory information presentEmpty property sets, absence of materialIDS Rule: mandatory attribute
ConsistencyNomenclature/structure standardizationDifferent names for the same elementLeaderboard check
AccuracyCorrespondence with reality/projectIncorrect volumes, wrong quotasModel X reference comparison
Semantic complianceCorrect use of IFC classesIfcBuildingElementProxy undueIFC schema validator
InteroperabilityInteroperability between softwareData loss on importPre and post-export comparison
Source: Original research results

However, the definition of requirements and the identification of technical challenges, in isolation, do not ensure the quality of the process. To be effective, these requirements need to be systematically planned, monitored, and verified. In this sense, project quality management offers a framework for structuring BIM information governance, by bringing together the processes of planning, managing, and controlling quality with the practices of digital information management (PMI, 2017; ABNT, 2022).

In planning, this relationship appears in the definition of informational requirements and acceptance criteria, such as EIR, BEP, LoIN, and IDS. In execution, it manifests in interdisciplinary coordination and continuous model validations. In control, it occurs through rule-based audits, indicators, and traceable evidence. This equivalence is synthesized in Table 4, which relates PMBOK processes to BIM information governance activities.

Table 4. Correlation matrix between PMBOK quality processes and BIM information governance activities, based on PMI (2017) and ABNT (2022)

PMBOK ProcessProcess objectiveEquivalent in BIM governancePractical examples
Plan QualityDefine criteria and standardsEIR, BEP, LoIN, IDSAttribute requirements, classification, acceptance criteria
Quality ManagementEnsure execution as plannedBIM Coordination, internal validations, model reviewsClash detection, property checking, standardization
Quality ControlVerify conformity of deliverablesIFC/IDS Audit, records, KPIsPercentage of filled attributes, non-conformity reports
Source: Original research results

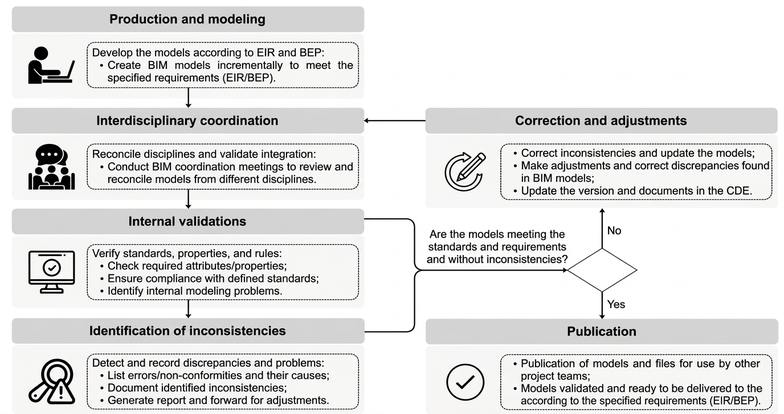

The flow presented in Figure 4 represents the sequence of activities that integrates modeling, interdisciplinary coordination, and successive checks before formal deliveries. This structure highlights that the reliability of the models depends on the articulation between production and intermediate checks, preventing the accumulation of inconsistencies. Figure 5 complements this approach by applying the PDCA cycle to the BIM context, relating requirements definition, execution, verification through rule-based audits, and adjustments resulting from the obtained outcomes. The integration between operational flow and continuous improvement sustains the systematic control of deliveries and the evolution of model maturity throughout the project.

Figure 4. Operational flow of execution, coordination, and continuous validations during the production of BIM models, based on PMI (2017), ABNT (2022), and Song et al. (2017)

Source: Original research results

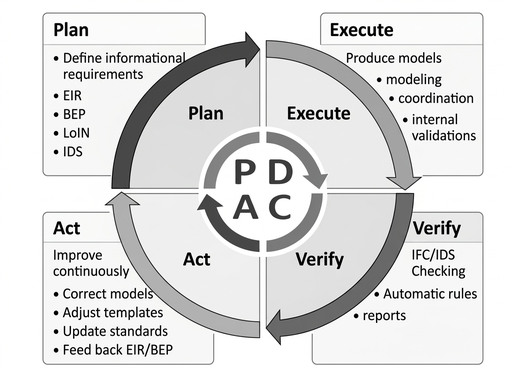

Figure 5. Application of the PDCA cycle to BIM information quality control, based on PMI (2017), ABNT (2022) and buildingSMART International (2025a)

Source: Original research results

As an integrative synthesis, the results indicate that BIM information governance can be structured coherently with the quality management processes of PMBOK. The definition of requirements corresponds to quality planning; the production of models and interdisciplinary coordination relate to quality management; and rule-based audits, indicators, and traceable evidence configure quality control. This articulation supports the continuous improvement of models and reinforces the application of project management references to the context of digital information.

This integration between normative requirements, interoperability, and quality management establishes the conceptual basis for the empirical stage of the research. The following section applies these principles to the analysis of road and rail infrastructure BIM models, seeking to identify, classify, and quantify recurring informational failures in a multiple case study.

Identification of informational failures in BIM models through a multiple case study

The empirical application of the discussed frameworks was carried out through a multiple case study involving two transport infrastructure ventures, one road and one rail, both in the executive design phase. The case studies included a road venture (a section of a duplicated federal highway with a grade-separated intersection) and a rail venture (interconnection between a rail yard and an iron plant), both provided by the multinational company Egis Group. The models cover typical linear infrastructure disciplines, such as geometry, earthworks, paving, drainage, special structures (OAE), permanent way, signaling, retaining structures, and interferences, developed in different BIM authoring software and exported to the IFC 4.3 format as an openBIM exchange standard. The analysis started from the information requirements defined in the respective contractual EIR and BEP, which specified mandatory attributes, classification criteria, modeling responsibilities, and planned BIM uses, such as quantification and interdisciplinary coordination. These documents served as the basis for defining the scope of the information audit and for verifying the adherence between what was contractually requested and what was effectively delivered in the models.

The analyzed elements were organized according to the life cycle phase, the actors involved, and the type of delivery contractually foreseen. The LoIN was operationalized by objectively explicating the attributes and documents required by discipline and purpose of use, avoiding generic classifications of detail level. Table 5 presents a synthesis of these parameters, structured into transversal and technical properties. This systematization allowed contractual requirements to be transformed into verifiable audit criteria, in coherence with the governance approach discussed previously.

Table 5. Synthesis of the informational requirements of BIM objects for linear infrastructure projects

BIM ObjectsCodeNameDisciplineLengthWidthHeightThicknessFieldQuantityDiameterWeight
Digital Terrain Model (DTM)XXXX
SurveysXXXX
Geological layersXXX
Water levelXXX
AlignmentsXXXX
Collection boxes, connection, passageXXXXX
Curb, gutters, ditches, drains, channelsXXXXX
Water descentsXXXXX
Energy dissipatorsXXXX
ManholesXXXXX
ManholesXXXX
TrenchesXXXX
Cuts, fills, CFT, reinforcements, loans, deposits (earthworks)XXXX
Clearing (earthworks)XXXXXX
Asphalt layersXXXXXXXX
Base, sub-base, subgrade, rigid, pavement and other coveringsXXXXXXX
Asphalt primerXXXX
Bonding paintXXXX
RailsXXXX
Concrete sleepers, woodXXXXXX
Ballast and sub-ballastXXXXXX
MudguardXXXX
AMV and bumperXXX
Brake shoeXXXX
Drainage geocompositeXXXX
Gabion, terramesh-system, terrameshgreenXXXXXX
Modular concrete facing (geotechnical containment)XXXXX
GeosyntheticXXXX
Geotechnical ties and drainsXXXXXX
Concrete facing (geotechnical containment)XXXXXX
Vertical and horizontal signageXXXX
Road safety barriers and defensesXXXX
License plate supports and energy absorbing terminalsXXXX
Guardrails, fences and designed wallsXXXX
Vegetation cover (landscaping)XXXX
Areas subject to expropriationXXXXX
Limits (domain range)XXXX
Existing fences and wallsXXXX
Existing treesXXXX
Existing poles, forests, roads, railways, and high-voltage towersXXXX
Existing toursXXXXXX
Existing buildingsXXXX
Lighting cablesXXXX
Lighting postXXX
Source: Original research results
Note: The properties were presented without the use of special characters, such as spaces and accents, in order to preserve syntactic compatibility and avoid inconsistencies in export, validation, and interoperability processes in an openBIM environment

Table 5 presents a summary of the informational requirements for BIM objects in linear infrastructures, structured into cross-cutting properties linked to the Work Breakdown Structure (WBS) and specific technical properties by element type. For Special Works (Obras de Arte Especiais – OAE) objects, the requirements followed the same structuring logic, including elements such as foundation blocks, footings, piles, columns, beams, decks, transition slabs, retaining walls, abutments, waterproofing, bearings, corbels, expansion joints, and guardrails. In addition to cross-cutting identification properties, such as code, name, and discipline, technical attributes associated with the geometric and quantitative characterization of these elements were considered, including length, width, height, thickness, shape area, volume, diameter, and weights of active and passive steel. This systematization allowed contractual requirements to be transformed into verifiable audit criteria, in coherence with the governance approach discussed previously.

From a technical point of view, the original models were produced in different authoring software and subsequently exported to the IFC 4.3 format, adopted as the openBIM exchange standard. A mapping of the IFC properties (Table 6) and entities (Table 7 and Table 8) used by discipline was performed, focusing on the correspondence between classes expected in the schema and the elements effectively exported. During this stage, recurring difficulties were identified related to inconsistent property export, use of generic classes, and loss of alphanumeric information, highlighting challenges already pointed out in the literature on semantic interoperability (Xu et al., 2018; Costin et al., 2018). These findings reinforce the premise that interoperability depends not only on the adoption of the IFC format but also on the correct structuring and validation of data.

Table 6. Mapping of IFC properties in BIM objects of the projects

Property SetIFC ParameterUnits of measureData Type
EAPCode–IfcIdentifier
Name–IfcLabel
Discipline–IfcLabel
[Project Phase]_[Discipline]_[Object] Examples:
Exe_DRE_Manhole
Exe_OAE_Beam
Length Widthm mIfcLengthMeasure IfcReal
HeightmIfcReal
ThicknessmIfcReal
Fieldm²IfcAreaMeasure
Quantitym³IfcVolumeMeasure
DiametermIfcReal
WeighttIfcReal
Form Aream²IfcAreaMeasure
ActiveWeightkgIfcReal
PassiveSteelWeightkgIfcReal
Source: Original research results

Table 7. IFC Mapping of BIM Objects from Linear Infrastructure Projects

Project DisciplineBIM ObjectsIFC Class (IfcClass)PredefinedType (PredefinedType)ObjectType
Topography (TOP)Digital Terrain Model (DTM)IfcGeographicElementLAND
Topography (TOP) or Interference Survey (CAD)FencesIfcRailingBarrier
Topography (TOP) or Interference Survey (CAD)WallsIfcWall
Topography (TOP) or Interference Survey (CAD)Trees, forestsIfcGeographicElementPLANT LIFE
Topography (TOP) or Interference Survey (CAD)Poles with luminairesIfcLightFixtureSOURCE DIRECTION
Topography (TOP) or Interference Survey (CAD)RoutesIfcRoad
Topography (TOP) or Interference Survey (CAD)RailwaysIfcRailway
Topography (TOP) or Interference Survey (CAD)High-voltage power linesIfcElementAssemblyTRUSS
Topography (TOP) or Interference Survey (CAD)ToursIfcSlabPavement
Topography (TOP) or Interference Survey (CAD)BuildingsIfcBuilding
Topography (TOP) or Interference Survey (CAD)SurveysIfcBorehole
Geology (GEG)Geological layersIfcGeotechnicalStratumRobust
Geology (GEG)Water levelIfcGeotechnicalStratumH2O
Geometry (GEO)AlignmentsIfcAlignment
Drainage (DRE)Collection boxesIfcDistributionChamberElementSUMP
Drainage (DRE)Junction boxes, pass-through and inspection boxesIfcDistributionChamberElementMaintenance hole
Drainage (DRE)CurbIfcKerb
Drainage (DRE)Gutters, drains and ditchesIfcPipeSegmentInner Margin
Drainage (DRE)DrainsIfcFlowSegmentUSERDEFINEDDrainage
Drainage (DRE)Water descentsIfcFlowSegmentUSERDEFINEDLeader
Drainage (DRE)Energy dissipatorsIfcFlowTerminalUSERDEFINEDEnergy_Dissipator
Drainage (DRE)ManholesIfcPipeSegmentDrainage conduit
Drainage (DRE)ManholesIfcWallEARTH-RETAINING STRUCTURE
Earthworks (TER)CutsIfcEarthworksCutCUT
Earthworks (TER)LandfillsIfcEarthworksFillDIKE
Earthworks (TER)Final earthworks layer (FEL)IfcEarthworksFillTransition Section
Earthworks (TER)Subgrade reinforcementIfcEarthworksFillSUBGRADEBED
Earthworks (TER)Pavement demolitionIfcEarthworksCutPAVEMENT MILLING
Earthworks (TER)CleaningIfcEarthworksCutTOPSOILREMOVAL
Paving (PAV)Asphalt layers, Asphalt priming, tack coat, base, sub-base, rigid, other pavementsIfcCoursePavement
Permanent way – railway superstructure (SUF)ToursIfcSlabPavement
Permanent way – railway superstructure (SUF)RailsIfcRailTRACK
Permanent way – railway superstructure (SUF)Concrete and wooden sleepersIfcTrackElementSLEEPER
Permanent way – railway superstructure (SUF)BallastIfcCourseBALLAST BED
Permanent way – railway superstructure (SUF)Sub-baseIfcCourseUSERDEFINEDSub-ballast
Permanent way – railway superstructure (SUF)MudguardIfcWallEARTH-RETAINING STRUCTURE
Permanent way – railway superstructure (SUF)AMVIfcTrackElement
Permanent way – railway superstructure (SUF)BumperIfcTrackElementVEHICLESTOP
Permanent way – railway superstructure (SUF)Brake shoeIfcTrackElementBLOCKINGDEVICE
Geotechnics (GET)Drainage geocomposite and geosyntheticIfcCourseScreen
Geotechnics (GET)Gabion, terramesh-system, terrameshverde and concrete facingIfcWallEARTH-RETAINING STRUCTURE
Geotechnics (GET)Tie RodsIfcTendonComponent
Geotechnics (GET)DrainsIfcPipeSegmentRIGIDSEGMENT
Signaling and Safety Devices (SDS)Vertical signageIfcElementAssemblySIGNALASSEMBLY
Signaling and Safety Devices (SDS)Horizontal signage (chevrons/symbols)IfcSurfaceFeaturePAVEMENT SURFACING MARKING
Signaling and Safety Devices (SDS)Horizontal signage (lines and edge markings)IfcSurfaceFeatureMARKING OF LINES
Signaling and Safety Devices (SDS)Road safety barriers and defensesIfcRailingSafety barrier
Complementary Works (OBC)FencesIfcRailingBarrier
Complementary Works (OBC)GuardrailIfcRailingSafety barrier
Complementary Works (OBC)WallsIfcWall
Complementary Works (OBC)Vegetation cover (landscaping)IfcGeographicElementPLANT LIFE
Expropriation (DES)Areas subject to expropriationIfcSpatialZoneUSERDEFINEDExpropriation Area
Expropriation (DES)Limits (domain range)IfcSpatialZoneUSERDEFINEDAdministrative Boundary
Lighting (ILU)Lighting cablesIfcCableSegmentCABLESEGMENT
Lighting (ILU)Post with luminairesIfcLightFixtureSOURCE DIRECTION
Source: Original research results

Table 8. IFC Mapping of BIM Objects from OAE Projects

Project DisciplineBIM ObjectsIFC Class (IfcClass)PredefinedTypeObject type (ObjectType)
Special Works of Art (SWA)           Foundation blocks and footingsIfcBridgePartFOUNDATION
Concrete pilesIfcPile–
Concrete columnsIfcColumn–
Concrete beamsIfcBeam–
Transition slabs and decksIfcBridgePartDECK_SEGMENT
Structural containmentsIfcWallEARTH-RETAINING STRUCTURE
MeetingsIfcBridgePartPILLAR
WaterproofingIfcCoveringMEMBRANE
Support devicesIfcDiscreteAccessoryUSERDEFINEDSupportPoint
Control panelsIfcDiscreteAccessorysquare bracket
Expansion jointsIfcDiscreteAccessoryEXPANSION_JOINT_DEVICE
GuardrailIfcRailingSafety barrier

The informational audit was based on the quality dimensions previously systematized and converted into verifiable criteria through IDS rules. Figure 6 presents an excerpt of the IDS structure in XML and its application in verifying models in Blender BIM (Bonsai), an open-source software based on the IfcOpenShell library, responsible for generating structured reports of non-conformities by model and discipline. Table 9 relates quality dimension, applied criterion, validation rule, and generated evidence, demonstrating how contractual requirements were translated into automated checks in the openBIM environment. This structure ensures traceability between the contractual LoIN, the IFC mapping, and the audit results, methodologically consolidating quality control.

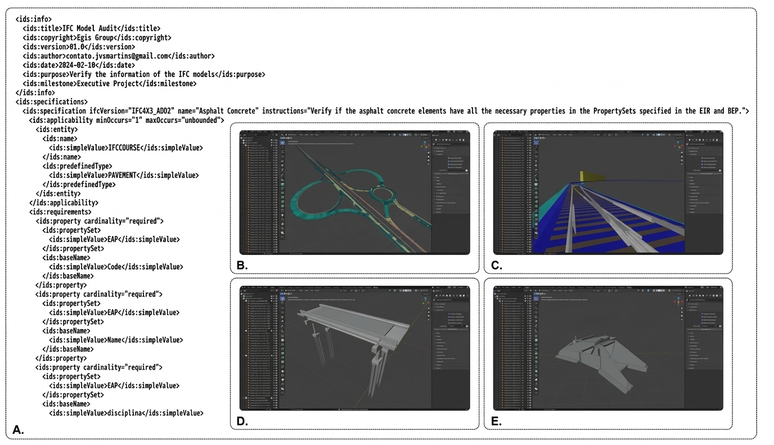

Figure 6. Excerpt from the IDS structure in XML and audit of models in Blender BIM (Bonsai): IDS XML structure (A); road project pavement model (B); permanent way model – railway superstructure (C); road project OAE model (D); railway project OAE model (E)

Source: Original research results

Table 9. Operationalization of informational quality dimensions in the audit of IFC models

Quality dimensionCriterion appliedOperational validation ruleAudit-generated evidence
CompletenessPresence of mandatory attributes defined in the contractual LoINIDS: mandatory property (required)Percentage of compliant elements and list of missing attributes
ConsistencyAdherence to the nomenclature standardization and classification system defined in the contractIDS: allowed value validation / divergent comparison with reference table disciplineList of divergent values by discipline
AccuracyCoherence between modeled geometry and quantities predicted in technical documentationAutomated extraction of quantities and comparison with contractual referencePercentage difference between model and baseline
Semantic complianceProper use of IFC PredefinedType classesIDS: Entity and attribute validation classified according to IFC 4.3 schemaList of incorrectly classified entities
InteroperabilityMaintaining integrity of IFC attributes export/importComparison of properties before and after IFC export and re-importList of lost, changed, or inconsistent attributes
Source: Original research results

The application of the rules to the road and rail models allowed for the objective quantification of the identified non-conformities, as presented in Table 10. The rail model presents a significantly larger number of analyzed elements, mainly due to the permanent way superstructure, with approximately 12,231 concrete sleepers individually modeled, which increases the total volume of evaluated objects and the absolute values of occurrences. However, when considering the percentage rates of non-conformity, similar behavior is observed between the two projects, indicating that the deviations do not arise solely from the scale of the models, but reflect structural patterns of governance and information control, reinforcing the need for systematic validations throughout production.

Table 10. Quantitative summary of non-conformities by model

ModelTotal elements analyzedTotal of non-conformitiesNon-compliance rate (%)
Road6.7771.56523,09%
Railway16.8474.38926,05%
Source: Original research results

The distribution of occurrences by discipline, presented in Figure 7, shows that certain areas concentrate a higher volume of inconsistencies, especially those associated with multiple technical attributes and strong dependence on standardization. This behavior confirms that informational quality in linear projects is directly related to the clarity of requirements and interdisciplinary coordination, in line with the interoperability challenges discussed. The heterogeneity observed between disciplines also demonstrates that informational maturity is not uniform within the same undertaking, an aspect relevant for comparative analyses and prioritization of corrective actions.

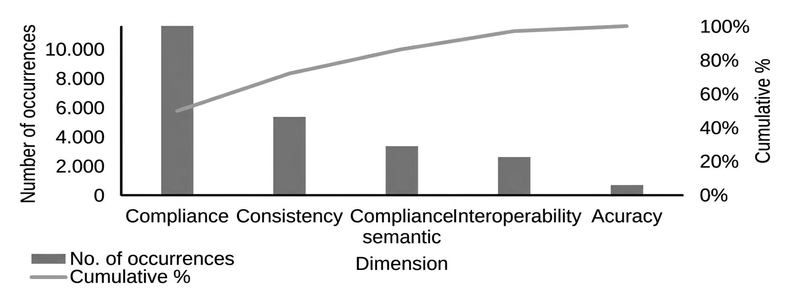

Figure 7. Recurrence of non-conformities by discipline and by project

Source: Original research results
Note: The figure presents only the disciplines that registered non-conformities during the audit. Disciplines without failures were not represented in the graph

Finally, the Pareto Analysis presented in Figure 8 reveals a significant concentration of non-conformities in the dimensions of completeness and consistency, while geometric accuracy, semantic compliance, and interoperability show a lower relative incidence. The cumulative curve shows that a restricted set of failure types accounts for the largest share of identified deviations, allowing for the prioritization of interventions without yet characterizing them as performance indicators. This empirical consolidation constitutes the objective basis for the development, in the following section, of structured criteria for evaluating the conformity and informational maturity of BIM models.

Figure 8. Pareto analysis of non-conformities identified by information quality dimension in the analyzed BIM models

Source: Original research results
Note: Abbreviations used: Comp. (Completeness), Consist. (Consistency), Semantic Conf. (Semantic Conformity) and Interop. (Interoperability)

Performance indicators for assessing compliance and informational maturity in BIM

The consolidation of non-conformities identified in the multiple case study allowed for the structuring of quantitative performance indicators aimed at the objective measurement of the informational quality of BIM models. Derived from previously operationalized quality dimensions, these indicators transform audit results into comparable metrics throughout the project cycle, enabling systematic evaluation of informational compliance and maturity. The corresponding mathematical expressions are presented in forms (1) to (5).

The Informational Completeness Index (ICI) can be calculated by means of eq. (1):

ICI= AC/AO ×100 (1)

where: AC: is the number of conforming attributes; and AO: is the number of mandatory attributes.

The Intraclass Correlation Coefficient (ICC) can be calculated using eq. (2):

ICC = EC/EA ×100 (2)

where: EC: is the number of correctly classified elements; and EA: is the number of evaluated elements.

The Semantic Compliance Index IFC (ICS) can be calculated by means of eq. (3):

ICS = Eifc/ET ×100 (3)

where: Eifc: is the number of elements with the correct IFC class; and ET: is the total number of elements.

The Interoperability Integrity Index (III) can be calculated using eq. (4):

III = API/AO ×100 (4)

where: API: is the number of attributes preserved after exchange; and AO: is the number of original attributes.

The Quantitative Accuracy Index (QAI) can be calculated by means of eq. (5):

IAQ = (1 – |Qmodel – Qreference|/Qreference) ×100 (5)

where: Qmodel: is the quantity automatically extracted from the BIM model; Qreference: is the quantity foreseen in the memorial, technical spreadsheet, or contractual basis.

The CI, defined in form. (1), corresponds to the ratio between compliant attributes (AC) and mandatory attributes (AO), expressing the degree of compliance with the requirements established in the contractual LoIN. The ICC, presented in form. (2), relates the number of correctly classified elements (EC) to the total number of evaluated elements (EA), reflecting the structural standardization level of the model. The ICS, form. (3), measures the proportion of elements with an adequate IFC class (Eifc) in relation to the total number of elements (ET), ensuring adherence to the IFC 4.3 schema. The III, form. (4), evaluates the preservation of attributes after IFC exchange, relating preserved attributes (API) to original attributes (AO). Finally, the IAQ, form. (5), measures the proximity between the quantities extracted from the model (Qmodelo) and the technical reference values (Qreferência), indicating the degree of model reliability for cost estimates and analyses.

Together, these indicators allow for the evaluation of performance by discipline and by model, overcoming the isolated analysis of non-conformities and enabling the evolutionary monitoring of informational quality throughout the project development. The consolidation of results was carried out through Business Intelligence (BI) dashboards, where the indices are visualized in an integrated manner by project and by quality dimension, providing a broader and more structured managerial view. This approach makes it possible to identify variations between disciplines, recognize critical points, prioritize interventions, and support evidence-based decision-making. Figure 9 presents the BIM informational quality dashboard applied to the road project, exemplifying the operationalization of indicators and the use of BI as a tool for information monitoring and governance.

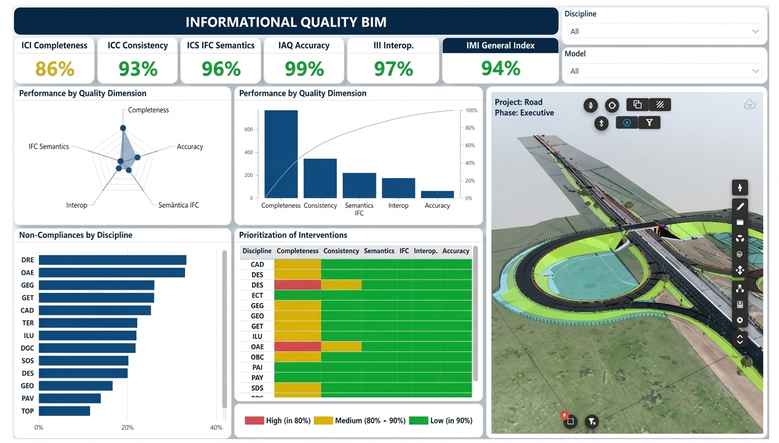

Figure 9. BIM information quality dashboard for highway project

Source: Original research results

The practical effectiveness of the indicators was observed in meeting one of the main BIM uses contractually foreseen in the multiple case study: the extraction of quantities and cost estimates. After the improvement of the indices, mainly completeness and consistency, the models could be quantified in a structured way in AltoQi Visus (Figure 10). The use of the Codigo property as a unique identifier, linked to the WBS and cost compositions, enabled the generation of traceable estimates aligned with the contractual scope.

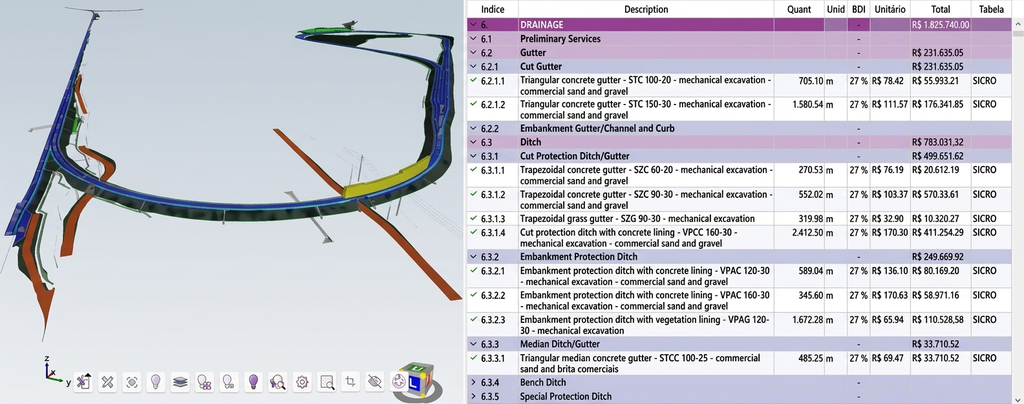

Figure 10. Extraction of quantities and cost estimation in AltoQi Visus from the BIM models of the railway project, linking properties to WBS codes and budget compositions

Source: Original research results

These results demonstrate that the proposed indicators are not limited to abstract metrics, but constitute operational instruments associated with the enablement of the foreseen BIM uses. The predominance of completeness and consistency failures reinforces that the adoption of IFC, in isolation, does not guarantee informational quality or full interoperability, requiring the prior definition of requirements, standardization of properties, and systematic validation of deliverables. The similarity between the percentage rates of non-conformity in road and rail projects suggests structural weaknesses in information governance processes, consolidating informational quality as a condition for value generation in infrastructure projects.

4. Conclusion

This work evidenced that the informational quality of BIM models is determinant for the reliability of information and for interoperability in transportation infrastructure projects. The case analysis demonstrated that inconsistencies in filling out properties, in element classification, and in data standardization compromise the use of models in analytical, managerial activities, and in contractual BIM uses, such as quantity extraction and cost estimations.

The articulation between informational requirements, BIM governance, and quality management allowed for the structuring of an approach to assess informational compliance. The audit structure and proposed indicators convert normative and contractual requirements into objective verification criteria. As a limitation, the application occurred in two case studies in the executive project phase and in a specific organizational context. As a future perspective, it is recommended to extend the proposal to other contexts, lifecycle phases, and common data environments.

Bibliographic References

Brazilian Association of Technical Standards [ABNT]. 2022. ABNT NBR ISO 19650 Series: Organization and digitalization of information about buildings and civil engineering works, including building information modeling (BIM) – Information management using building information modeling. Rio de Janeiro, May 27, 2022.

Brazilian Association of Technical Standards [ABNT]. 2023. ABNT NBR ISO 16739-1: Industry Foundation Classes (IFC) for the sharing of data by the construction and facility management industries – Part 1: Data schema. Rio de Janeiro, Dec. 29, 2023.

buildingSMART International. 2025a. IDS: Computer interpretable (XML) standard to define Information Delivery Specifications for BIM. Available at: . Accessed: 28 Oct. 2025.

buildingSMART International. 2025b. IFC 4.3.2 Documentation. Available at: . Accessed on: 28 Oct. 2025.

Costin, A.; Adibfar, A.; Hu, H.; Chen, S. 2018. Building Information Modeling (BIM) for transportation infrastructure – Literature review, applications, challenges, and recommendations. Automation in Construction 94: 257-281.

International Organization for Standardization [ISO]. 2024. ISO 7817-1:2024: Building information modelling – Level of information need – Part 1: Concepts and principles. Geneva, 19 Jun. 2024.

Project Management Institute [PMI]. 2017. A Guide to the Project Management Body of Knowledge. 6th ed. Project Management Institute, Newton Square, PA, USA.

Song, J.; Migliaccio. G.; Wang, G.; Lu, H. 2017. Exploring the Influence of System Quality, Information Quality, and External Service on BIM User Satisfaction. Journal of Management in Engineering 33 (6): 04017036.

Tomczak, A.; Benghi, C.; van Berlo, L.; Hjelseth, E. 2024. Requiring Circularity Data in BIM With Information Delivery Specification. Journal of Circular Economy 1(2): 1-13.

Xu, Z.; Huang, T.; Li, B.; Li, H.; Li Q. (2018). Developing an IFC-Based Database for Construction Quality Evaluation. Advances in Civil Engineering 2018(1): 1-22.

Zhao, L.; Liu, Z.; Mbachu, J. 2019. Highway Alignment Optimization: An Integrated BIM and GIS Approach. ISPRS International Journal of Geo-Information 8(4): 172.

Article originating from the Final Course Work of the Specialization in Project Management of the MBA USP/Esalq

To learn more about the course, click here and access the MBX Academy platform

You may also like

Economy, Investments And Banking

October 23, 2026

Financial Education, Behaviors and Biases in Financial Decision Making

Personal financial management represents a growing challenge, influenced by cognitive biases that affect decision-making, even in individuals with high knowledge. The present study analyzed the relationship between the level of financial education and the occurrence of behavioral biases in the financial decision-making of adults residing in Brazil. An applied, quantitative, and descriptive-correlational field survey was conducted by administering a structured questionnaire to 163 respondents. The instrument included sociodemographic variables, financial knowledge and habits, and hypothetical situations to identify cognitive biases. The results indicated that higher levels of financial education were associated with better financial control, saving, and investment practices, with significant correlations with income and schooling. However, the presence of behavioral biases (anchoring, loss aversion, scarcity, optimism/negativity, present bias, status quo, overconfidence, and mental accounting) persisted even among individuals with higher schooling and income, with no statistically significant association with the analyzed sociodemographic variables. It was concluded that financial education, although essential for financial organization and control, was not sufficient to neutralize the influence of cognitive biases. The incorporation of behavioral approaches into financial education programs is suggested.

Keywords: Financial behavior; Behavioral economics; Personal finance; Cognitive heuristics; Cognitive biases.

October 22, 2026

Consumer Journey in the Decision to Purchase Infoproducts in the Digital Environment

The expansion of e-commerce and technological transformation have driven the need to understand consumer behavior regarding infoproducts, whose perceived experience has become crucial for professional development. The study aimed to analyze the factors that influenced the purchase decision of infoproducts in the digital environment, considering the stages of the consumer journey. An applied, quantitative, and descriptive research was conducted through a field survey with 100 consumers from Serra Gaúcha. Data collection occurred via a structured questionnaire, using non-probabilistic sampling. The results revealed a qualified audience with strong “mobile-first” behavior. It was found that the availability of detailed information and social approval were the main attraction triggers in the pre-purchase phase. In the transactional and subsequent stages, the minimization of operational friction, the agility of immediate access, and system security proved crucial for conversion and satisfaction, although gaps in human support efficiency were identified. Retention was based on the trust generated by positive past experiences, overcoming the price factor. It was concluded that the infoproduct consumer journey operates as an integrated system, requiring alignment between technological infrastructure, content curation, and support humanization to ensure engagement.

Keywords: E-commerce; Consumer behavior; Consumer experience; Loyalty; Virtual business.

October 22, 2026

Forecast of Aggregate Default in the Brazilian Financial System by Sarimax Model with Macroeconomic Variables

Aggregate non-payment in the Brazilian financial system is a crucial indicator of credit risk, the prediction of which is regulated by CMN Resolutions n.° 4.557/2017 and 4.966/2021 for the prospective measurement of expected losses. Aggregate non-payment was modeled and predicted using the SARIMAX model, projecting its trajectory until December 2026 under optimistic, base, and pessimistic scenarios. 164 monthly observations (July/2012 to February/2026) and macroeconomic variables such as unemployment, Selic, IPCA, IBC-Br, and household debt were used. The specification with contemporaneous variables was selected based on information criteria and coefficient stability, and residual diagnostics confirmed statistical adequacy, with a MAPE of 3.12%. Historical non-payment ranged between 4.33% and 7.64%. The estimation identified unemployment (β = 0.2534; p < 0.001) and Selic (β = 0.2128; p < 0.001) as the main positive determinants, with strong temporal persistence (AR(1) = 0.8965). Selic showed increasing correlation with non-payment (r = 0.62 at lag 12), while unemployment demonstrated a contemporaneous effect (r = 0.33). Projections indicated non-payment between 6.30% and 7.98% in December 2026, with a range of 1.68 percentage points, highlighting direct implications for provisioning in financial institutions.

Keywords: Unemployment; Predictive modeling; Monetary policy; Loss provisioning; Time series.
